In the process of handling custom corporate stationery orders, there is one phase that is frequently and severely underestimated: the conversion from "sample approval" to "production specifications." The reason this phase tends to go wrong is not because clients are careless or suppliers are unprofessional, but because both parties have fundamentally different understandings of what "approval" actually means.
When a client receives a sample and responds with "confirmed" or "OK," they are typically expressing approval of the visual presentation—the color looks right, the logo placement seems reasonable, and the overall quality meets expectations. But from the factory's perspective, this kind of confirmation only completes a small portion of the entire specification lock-down process. The actual production specifications need to cover far more than just visual aspects: specific material codes, Pantone color numbers, dimensional tolerances, precise coordinates for print placement, packaging methods, and stacking specifications.
The consequences of this cognitive gap often don't surface until the mass production phase. For example, a client approves a sample of a custom notebook but doesn't explicitly specify the acceptable weight range for the inner pages. The sample was made with 100gsm paper, but during mass production, the factory uses 90gsm paper from the same series due to material scheduling. From a technical specification standpoint, this substitution is reasonable—because the client never explicitly required "must be 100gsm." But when the client receives the finished products, they feel the "texture is thinner" and "quality has declined." This isn't negligence on the factory's part; it's information loss during the specification conversion process.

An even more common situation occurs in color management. When clients approve samples, they typically view them under office fluorescent lighting. But color calibration during mass production is based on Pantone numbers or CMYK values. If color standards aren't locked down simultaneously during the sample approval phase, the colors of mass-produced items may vary subtly due to different ink batches, different printing machines, or even different paper surface treatments. These variations may all be within technically acceptable ranges, but the client's visual memory will perceive them as "different from the sample."

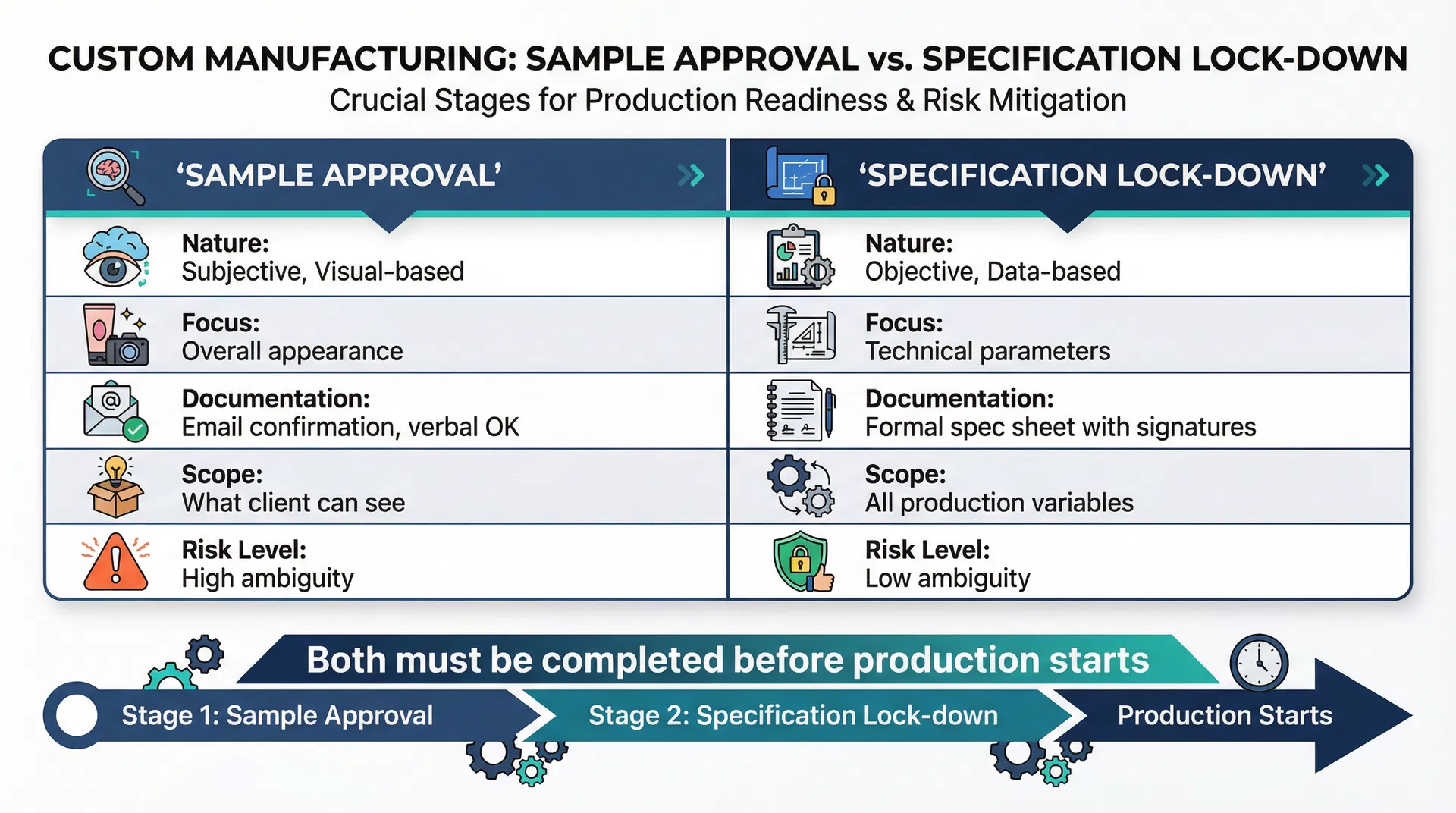

From a project management perspective, the root of this problem lies in conflating "sample approval" with "specification lock-down." Sample approval is a subjective, visually-based recognition process; specification lock-down is an objective, data-based technical document finalization. These two should be conducted separately, but in practice, many orders enter production scheduling after completing only the former.
In the complete procurement process for custom stationery, the design confirmation phase is typically viewed as a milestone. But the completion criteria for this milestone are often too vague. A complete specification lock-down should encompass several layers: First, material specifications—not just category descriptions like "leather" or "canvas," but specific material codes, supplier batch numbers, and acceptable alternatives. Second, color specifications, including Pantone numbers, CMYK values, and acceptable color deviation ranges on different materials (usually expressed as Delta E values). Third, dimensional specifications—not just nominal length, width, and height values, but also clearly defined positive and negative tolerance ranges. Fourth, printing specifications, including print position coordinates, print area dimensions, and specific parameters for the printing process.

Part of the reason this specification conversion blind spot is difficult to avoid is the timing of communication. Many clients don't have clear ideas about detailed specifications at the beginning of a project—they only have a general visual concept. To move the project forward, suppliers will first assume certain parameters based on experience to create samples. Once the sample is approved, these "assumptions" are tacitly treated as "specifications," but they were never formally confirmed in writing.
Another common issue is the absence of a "specification freeze point." In professional manufacturing processes, there is a clear point in time after which any specification changes require a formal change process and reassessment of cost and delivery impacts. But in many custom corporate stationery orders, this freeze point either doesn't exist or is repeatedly breached. Clients request "can we move the logo up a bit" or "can we change to a different color" after mass production has started, and suppliers often try to accommodate to maintain client relationships. This accommodation may seem to solve the problem in the short term, but in the long run, it undermines the effectiveness of the entire specification management system.
From a risk control perspective, oversights during the specification conversion phase are often amplified in subsequent phases. A tolerance definition ignored during sampling could cause dimensional deviations in hundreds or thousands of products during mass production. A color standard that wasn't explicitly locked down could result in visible color differences between different batches. The cost of correcting these issues is far higher than spending a few extra days during the specification conversion phase for detailed confirmation.
In practice, the key to reducing these problems is to explicitly separate "sample approval" from "specification lock-down." Sample approval can be a relatively quick visual recognition process, but before entering production scheduling, there must be a complete specification document confirmed in writing by both parties. This document should cover all parameters that could affect finished product quality, not just the few items the client actively focuses on. For parameters the client hasn't explicitly requested, suppliers should proactively propose recommended values and seek confirmation, rather than silently making assumptions.
This process may appear to increase upfront communication costs, but from an overall project perspective, it actually reduces later-stage change costs and quality risks. An order that has undergone complete specification lock-down has a significantly lower probability of disputes during the mass production phase, and both parties' expectations for the finished products will be much more aligned.
